East Middleton Force Main and CP-2 Outfall Blasting
12 de marzo de 2026
CP-1 Updates
Haren teams are preparing the site in anticipation of expected rain.
JFW crews will continue installation of the 16-inch force main along East Middleton Drive and will remain active between Stardust Lane and West Middleton Drive as 24-inch force main installation continues.
CP-2 Updates

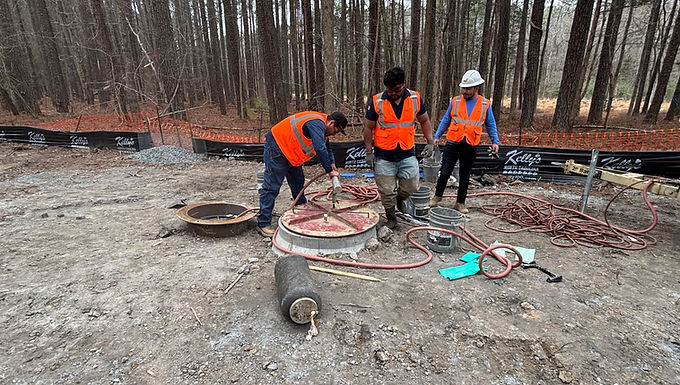

Park crews will continue installing FRP sewer mains and backfilling disturbed areas. Crews will also continue grouting pipe inverts within structures and performing vacuum testing on manholes.
Carolina Drilling is scheduled to blast a section of rock in the outfall at 10:00 AM. This work is not occurring in the roadway and is therefore not subject to the current stop work order from Enbridge.
