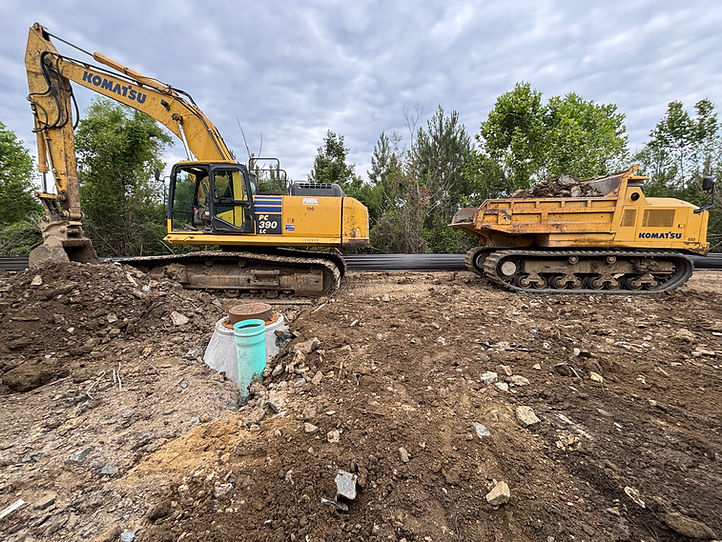

Construction Workers Measuring

Proyecto SSI I-85

La Autoridad de Agua y Alcantarillado de South Granville se asoció con los expertos en ingeniería CDM Smith para llevar a cabo el Proyecto de Mejora del Alcantarillado Sanitario I-85.

Este proyecto reemplazará materiales obsoletos para mantener una infraestructura que satisfaga las demandas de capacidad presentes y futuras del condado de Granville.

Construction Tape.png

SOCIOS DEL PROYECTO

Consulte la información diaria del plan de trabajo de campo del Proyecto de Mejora del Alcantarillado Sanitario I-85 de SGWASA, recibida de los Representantes Residentes del Proyecto.

Próxima actualización:

29 de septiembre de 2026

28 de septiembre de 2026

Two Controlled Blasts Scheduled as A Street and Underground Work Advance

CP-1 Updates
Haren is progressing work at the Joe Peed lift station. Along Joe Peed Road, JF Wilkerson is continuing sewer line installation while Autry advances sewer force main construction.

CP-2 Updates
Park Crews are continuing pipe installation on A Street. Young Construction is advancing I-85 microtunnel boring, while a second Young crew continues Norfolk Southern Railroad bore activities. Carolina Drilling is scheduled to conduct two controlled blasts today at 11:00 AM and 3:00 PM.


Blasting returns to today’s I-85 SSI construction schedule, with two controlled blasts planned for 11:00 AM and 3:00 PM. Progress continues at the Joe Peed lift station, along Joe Peed Road, on A Street, and within both the I-85 microtunnel and Norfolk Southern Railroad bore areas.

Actualizaciones de construcción:

25/9/26, 5:17 a.m.

The next phase of I-85 SSI construction brings active sewer installation, tunneling, blasting preparation, and traffic changes to several project areas. Along Joe Peed Road, one crew has demobilized from the former lift station area while a plan is developed for disposal of contaminated soil. The crew is expected to return when the remaining gravity sewer work is available. A second crew is continuing installation of the 20-inch force main from Joe Peed.

Motorists traveling near the new Joe Peed pump station should expect periodic flagging and lane closures this week as force main construction moves forward. Lane closures are also anticipated next week as this work progresses along Joe Peed Road.

In the CP-2 area, Park is continuing pipe installation on A Street and preparing C Street for Carolina Drilling by excavating the air gap needed for upcoming blasting operations. Young Construction is advancing the I-85 microtunnel casing and continuing tunneling operations. Controlled blasting is planned on C Street.

Customers and motorists should be aware of the following expected impacts.
Joe Peed Road: Periodic flagging and lane closures near the new Joe Peed pump station
A Street: Full closure
8th Street: Full closure
C Street: Full closure

No partial road closures are currently identified within the CP-2 work plan.

Construction schedules and traffic controls may be adjusted as field conditions require. Motorists are encouraged to follow posted signage, allow additional travel time, and use caution near crews and equipment.

SGWASA appreciates the community’s continued patience and cooperation as crews advance these wastewater infrastructure improvements.
